Gunite vs Shotcrete Pool Strength: 4,000 PSI Specs

Compare gunite and wet-mix shotcrete pool strength: 4,000 psi (28 MPa) 28-day specs, w/cm 0.30-0.42 control, ASTM C1140 core testing, and rebound disposal.

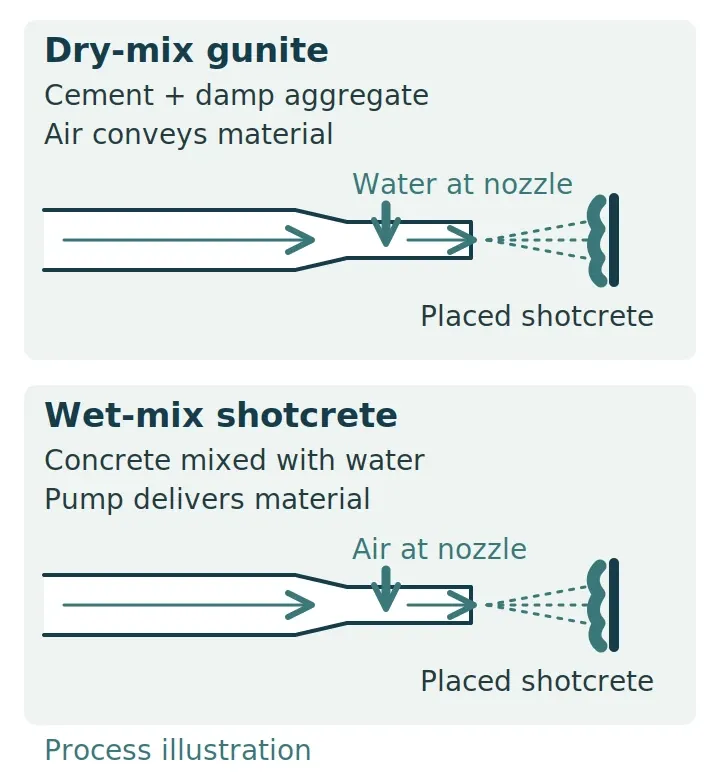

Side-by-side schematic comparing dry-mix gunite water injection at the nozzle and wet-mix shotcrete ready-mix pumping against shared 4,000 psi, 0.30 to 0.42 w/cm, 60 to 80 mph impact, and zero rebound reuse benchmarks
Both dry-mix gunite and wet-mix shotcrete achieve 4,000+ psi (28 MPa) structural pool shells when water-cementitious ratios, nozzle pressures, impact velocity, and rebound disposal meet ACI and USDA NRCS standards.

Direct answer

Neither dry-mix gunite nor wet-mix shotcrete is inherently stronger in PSI. Both pneumatic placement methods produce equal structural pool shells meeting the American Shotcrete Association minimum of 4,000 psi (28 MPa) at 28 days and typical 0.30 to 0.42 water-cementitious ratios when verified by ASTM C1140 panel cores and strict rebound removal.

Key takeaways

  • ACI 506R-16 classifies shotcrete at 4,000 psi or higher as structural, and the American Shotcrete Association maintains a 4,000 psi (28 MPa) minimum 28-day compressive strength for both dry-mix gunite and wet-mix shotcrete.
  • Shotcrete achieves a lower w/cm (0.30 to 0.42) than typical form-and-place concrete (0.40 to 0.50); dry-mix regulates water at the nozzle while wet-mix fixes w/cm in ASTM C94 batching before pumping.
  • Pool shells cannot be verified with cast cylinders alone; ASTM C1140 requires production test panels at least 18 in. square by 6 in. thick shot in the same orientation and cored for three-specimen ASTM C39 testing.
  • Rebound is aggregate-rich and cement-poor; USDA NRCS CS 33 and ASA strictly ban reusing rebound or burying it in coves, floors, steps, or benches.

Neither dry-mix gunite nor wet-mix shotcrete has an inherent compressive-strength advantage in a swimming pool shell. Both pneumatic placement methods build equal structural concrete meeting the 4,000 psi (28 MPa) 28-day minimum and 0.30 to 0.42 water-cementitious ratio (w/cm) when backed by ASTM C1140 panel core testing, verified nozzle pressures, and complete rebound disposal across your pool construction plan.

Is gunite stronger than wet-mix shotcrete in PSI for a swimming pool shell?

Dry-mix gunite and wet-mix shotcrete deliver equivalent structural compressive strength when properly proportioned, placed, and cured. Under ASA Position Statement #2 (Definitions of Key Shotcrete Terminology), shotcrete is the overarching process in which concrete travels through a hose and is pneumatically projected at high velocity onto a receiving surface to achieve dense, low-permeability compaction. Gunite is the original trade name for dry-mix shotcrete, where most mixing water enters at the nozzle, whereas wet-mix shotcrete arrives completely mixed with water before entering the delivery hose and receives compressed air at the nozzle.

Both USDA NRCS National Engineering Handbook, Part 645, Chapter 14: Shotcrete and USDA NRCS Construction Specification 33—Shotcrete permit either the dry-mix or wet-mix process unless the designer specifies one, noting that either process meets most design requirements. In ASA technical guidance (Misconceptions about Shotcrete), ASA Executive Director Charles Hanskat confirms that dry-mix shotcrete built with quality materials, sound mix design, proper equipment, and experienced nozzlemen produces in-place concrete equal to wet-mix shotcrete. For terminology background before comparing bid scopes, see our gunite vs shotcrete comparison.

Structural 4,000 PSI benchmark and why 2,500 PSI signals a defect

According to National Ready Mixed Concrete Association (NRMCA) CIP 35 (Testing Compressive Strength of Concrete), compressive strength equals the maximum load at failure divided by the resisting cross-sectional area, reported in pound-force per square inch (psi) or megapascals (MPa). While conventional concrete spans from 2,500 psi (17 MPa) in basic residential flatwork to 4,000 psi (28 MPa) and above in commercial structures and over 10,000 psi (70 MPa) in specialty structures, pool shotcrete carries a stricter floor:

  • Structural classification: USDA NRCS NEH Chapter 14 cites ACI 506R-16 as classifying any shotcrete with a designed compressive strength of 4,000 psi or greater as structural shotcrete.
  • 28-day pool shell minimum: ASA maintains that all shotcrete should achieve a minimum compressive strength of 4,000 psi (28 MPa) at 28 days.
  • Defective strength flag: ASA warns that a core test result of 2,500 psi (17 MPa) is very low for shotcrete and points to improper materials, equipment failure, or poor nozzling technique.
  • Target overdesign margin: NRMCA CIP 35 distinguishes the engineer’s specified strength (f’c) from the higher required average strength (f’cr) that mix designers target so compliance failure probability stays very low.
  • Long-term hydration: Concrete does not lose strength with age; ongoing moisture exposure hydrates remaining unhydrated cement, increasing strength, reducing permeability, and strengthening concrete even past 100 years.

High compressive strength alone cannot compensate for uncompacted subgrade or undersized steel, so coordinate structural mix approvals alongside soil testing and excavation engineering and pool rebar grid spacing and cover checks.

How do gunite and wet-mix shotcrete equipment control water-cementitious ratio (w/cm) and pressure?

Water-cementitious material ratio (w/cm) is the total weight of water—including water carried in high-range water-reducing admixtures (HRWRA)—divided by the total weight of cementitious materials such as portland cement, fly ash, silica fume, or slag. ASA reports that shotcrete typically operates at a lower w/cm of 0.30 to 0.42 compared with 0.40 to 0.50 for most form-and-place concrete, driving faster early strength gain and higher 28-day compressive and tensile strengths. Where that water enters the stream determines which equipment gauges and tickets control your pool shell.

Dry-mix gunite pressure and predampening controls

In dry-mix gunite, dry cement and aggregate are predampened before entering the gun to bring aggregate moisture content to 3 to 6%, per ASA Position Statement #2. USDA NRCS CS 33 requires feeding that predampened mix through a vibratory screen into a single-chamber batch gun, double-chamber airlock gun, or continuous-feed rotary airlock gun, and shooting it within 45 minutes of mixing (or within 15 minutes when ambient temperatures exceed 85 °F), wasting any mix that dries out or cakes.

Because the nozzleman regulates mixing water in real time at the nozzle ring, ASA notes that dry-mix tends to achieve a lower w/cm than wet-mix—but an inattentive nozzleman or insufficient water pressure can leave porous dry spots. To prevent dry pockets, USDA NRCS CS 33 requires compressors capable of regulating air pressure between 50 and 80 psi and maintaining water pressure between 50 and 100 psi. Specifically, gun air pressure must stay at or above 40 psi plus 5 psi for every 50 feet of hose beyond 100 feet and 5 psi for every 25 feet the nozzle sits above the gun, while nozzle water pressure must stay at least 15 psi higher than gun air pressure.

Wet-mix shotcrete batching and pumping tolerances

In wet-mix shotcrete, all cement, aggregate, water, air-entrainment, and chemical admixtures (except nozzle-injected accelerators) are batched prior to delivery in ready-mix trucks conforming to ASTM C94, then fed into a positive-displacement concrete pump where compressed air enters at the nozzle solely to accelerate impact velocity. Because no water is adjusted at the nozzle, mix consistency depends on plant batching accuracy and discharge timing.

USDA NRCS CS 33 establishes tight batch tolerances of plus or minus 2% for cement, plus or minus 4% for aggregate, and plus or minus 6% for admixtures on scales accurate within 0.4% of capacity, while capping fly ash or pozzolan added for consistency at 20% of cement weight. Every wet-mix load must be fully discharged before loading the next batch and gunned within 1.5 hours of batching in normal weather, dropping to 45 minutes above 85 °F. Any wet-mix load that stiffens and becomes difficult to pump must be discarded immediately.

Process parameter comparison

Scroll horizontally to read all columns.

Specification parameter Dry-mix shotcrete (Gunite) Wet-mix shotcrete Governing standard
Mixing water entry Injected at nozzle water ring after predampening Batched with cement and aggregate before pumping ASA PS #2 / CS 33
Typical shotcrete w/cm range 0.30 to 0.42 (tends toward lower end) 0.30 to 0.42 (fixed on ASTM C94 batch ticket) ASA Fall 2016
Aggregate predampening 3% to 6% moisture before feeding gun Not applicable (full wet batching) ASA PS #2
Delivery equipment Batch, double-chamber, or rotary airlock gun Positive-displacement concrete pump + air compressor USDA NRCS NEH Ch. 14
Air and water pressure control Air 50 to 80 psi; water 50 to 100 psi (at least 15 psi above gun air) Compressed air added at nozzle to control velocity USDA NRCS CS 33
Batch time limit (normal / over 85 °F) 45 minutes / 15 minutes after mixing 1.5 hours / 45 minutes after batching USDA NRCS CS 33
Batch weight tolerances Cement ±2%, aggregate ±4%, admixtures ±6% (scale 0.4%) Cement ±2%, aggregate ±4%, admixtures ±6% (scale 0.4%) USDA NRCS CS 33
Vertical build without sloughing Minimum 0.75 in. adherence per lift Minimum 0.75 in. adherence per lift USDA NRCS CS 33

Worked dry-mix pressure calculation

Suppose a dry-mix gunite rig parks at the street with 200 feet of delivery hose running level (0 feet elevation rise) into the backyard excavation. Hose length exceeds the 100-foot baseline by 100 feet, equal to two 50-foot increments (2 multiplied by 5 psi equals 10 psi). Adding that 10 psi to the 40 psi base sets minimum gun air pressure at 50 psi. Because nozzle water pressure must exceed gun air pressure by at least 15 psi, the water booster gauge must maintain at least 65 psi at the nozzle to hydrate the stream evenly without dry pockets.

Engineering comparison chart of dry-mix gunite air and water pressure limits versus wet-mix shotcrete ASTM C94 batching tolerances, batch time limits, and a 200-foot hose dry-mix pressure calculation
USDA NRCS Construction Specification 33 and ASA field thresholds for dry-mix gunite nozzle water/air pressures versus wet-mix ASTM C94 batching tolerances and working-time limits.

How is a 4,000 psi concrete pool shell tested with ASTM C1140 panels and cores?

Verifying a 4,000 psi concrete pool shell requires coring pneumatically shot production test panels rather than casting standard concrete cylinders at the truck chute. As USDA NRCS NEH Chapter 14 explains, the high-velocity spraying process makes it impossible to fill and compact a standard compressive strength cylinder the way crews mold conventional poured concrete. Instead, ASTM C1140/C1140M (Standard Practice for Preparing and Testing Specimens from Shotcrete Test Panels) governs preparing dry-mix or wet-mix panels and testing sawed or cored specimens for preconstruction studies, nozzleman and equipment qualification, quality control, and compressive or flexural strength verification.

Production test panel dimensions, coring, and lab curing

Under USDA NRCS CS 33 and NEH Chapter 14, testing follows four non-negotiable rules that link panel results to the real pool shell:

  1. Nozzleman qualification before shooting: Each nozzleman must submit a resume documenting at least 1 year of experience in the specific shotcrete process, hold ACI CP-60 certification, and shoot an engineer-observed preconstruction test panel demonstrating proper air/water prep, rebar encasement, and defect cutout.
  2. Panel geometry and orientation: Production test panels must measure at least 18 inches square and 6 inches thick, be shot only when the engineer is present, and match the vertical or overhead orientation of the structural work.
  3. Standard lime-water curing: Cores drilled from the panels must enter standard curing in lime-saturated water maintained at 73.4 °F plus or minus 3.0 °F within 24 hours after removal, while continuing initial cure until standard curing begins.
  4. Three-core averaging and ASTM C39 testing: Each strength test breaks three cores in compression and averages the three values; if one core shows manifest sampling, coring, or testing defects, it is discarded and the remaining two are averaged, whereas defects in more than one core invalidate the entire test.

Under ASTM C31 and ASTM C39 summarized in NRMCA CIP 35, standard-cured specimens (such as 4x8 in. or 6x12 in. cylinders in conventional testing, or standard-cured panel cores in shotcrete) establish mix acceptance and quality control, whereas separate field-cured specimens estimate in-place concrete strength. Hydraulic testing machines operated by certified technicians under ACI 318, ACI 301, and ASTM C1077 load specimens at 28 to 42 psi/s (0.20 to 0.30 MPa/s) during the latter half of loading and report the average strength to the nearest 10 psi (0.1 MPa).

Worked 4,000 psi acceptance evaluation and lab precision checks

Under NRMCA CIP 35 acceptance rules, concrete complies with specified strength (f’c) only when two criteria pass simultaneously: the average of any 3 consecutive strength tests equals or exceeds f’c, and no individual test falls below f’c by more than 500 psi (3.5 MPa)—or by more than 0.10 f’c when specified strength exceeds 5,000 psi (35 MPa). For a 4,000 psi pool shell, the single-test floor is 3,500 psi.

Scroll horizontally to read all columns.

Evaluation case Three consecutive 28-day tests (psi) 3-test average (psi) Lowest single test (psi) Compliance decision (f’c = 4,000 psi)
Case A: One dip above floor 4,420 / 3,860 / 4,290 4,190 3,860 Pass (average at least 4,000; single at least 3,500)
Case B: Single test below floor 4,510 / 3,390 / 4,480 4,127 3,390 Fail (3,390 falls more than 500 psi below 4,000)
Case C: Low rolling average 3,920 / 3,890 / 4,010 3,940 3,890 Fail (average 3,940 falls below 4,000 specified)

When a test fails compliance, NRMCA CIP 35 cautions that deviations in fabrication, handling, curing, or testing frequently lower measured strength rather than reflecting defective concrete. Audit lab precision alongside mix records: companion specimens tested at the same age should maintain a 2 to 3% coefficient of variation, spreads exceeding 8% for two specimens or 9.5% for three more than 1 time in 20 trigger laboratory procedure audits, and results from two labs testing the same sample should not diverge by more than about 14%. Finally, while a 3- or 7-day break helps spot early mix or laboratory problems, it is never a standalone basis for rejecting concrete specified at 28 days.

Four-step testing chain from 18 by 18 by 6 inch ASTM C1140 shotcrete panels through lime-water core curing, ASTM C39 compression breaks, and a worked 4,000 psi three-test acceptance table with lab precision flags
ASTM C1140 panel preparation, lime-water core conditioning, ASTM C39 compression testing, and NRMCA CIP 35 three-test acceptance math for a 4,000 psi pool shell.

Why is rebound material disposal critical in gunite and shotcrete shells?

Rebound is material that bounces off the receiving surface during pneumatic shooting, consisting primarily of coarse sand and rock with far less cementitious paste than the original mix. Because it lacks paste, ASA explains that rebound is substantially weaker and more porous than structural shotcrete. Sweeping rebound into floor-to-wall coves or shoveling it into steps and benches creates weak, porous planes inside the shell that stop the basin from acting monolithically and trigger cracking and delaminations through seasonal wetting, drying, and thermal cycles.

Both ASA and USDA NRCS CS 33 state the rule without exception: rebound material must never be remixed, reused, or incorporated into any part of the structural pool shell, and fresh shotcrete must never be sprayed over accumulated rebound.

Nozzle distance, blowpipe clearing, and banning hand-packed concrete

Achieving dense compaction while keeping rebound out of structural corners relies on four observable placement habits:

  • Impact velocity and compaction: ASA Position Statement #2 sets ideal particle impact velocity at 60 to 80 mph (100 to 130 km/hr), and ASA field guidance notes average impact velocities of 50 to 80 mph (80 to 125 km/hr) compact and consolidate the shell without external vibration.
  • Nozzle angle and distance: USDA NRCS CS 33 requires holding the nozzle 2 to 6 feet from and approximately perpendicular (90 degrees) to the receiving surface, filling corners first, and shooting vertical walls from the bottom up.
  • Dedicated blowpipe clearing: A nozzleman’s helper operates a compressed-air blowpipe (air lance) ahead of the spray stream to blow rebound and loose sand away from rebar cages, preventing porous shadows behind reinforcing bars and removing accumulated rebound from forms, subgrade, and finished surfaces.
  • Zero hand-packing of stiff concrete: ASA explicitly warns against wheelbarrowing stiff, unpumpable wet-mix concrete into open floor, step, or bench areas and hand-packing it; without high-velocity pneumatic impact, hand-packed sections trap random voids, bond poorly to adjacent shotcrete, and leak.

Defect removal and 45-degree edge repair standards

ASA emphasizes building the shotcrete basin as an essentially watertight structural shell rather than relying on interior plaster to bridge honeycombing or porous spots. Plaster has different strength, shrinkage, and thermal expansion behavior than structural concrete and cannot supply missing structural strength or fill voids.

Under USDA NRCS CS 33, sags or sloughs must be cut out and regunned before the underlying shotcrete sets. If hardened shotcrete exhibits drummy areas, segregation, honeycombing, laminations, dry patches, slugs, voids, or sand pockets, the contractor must obtain the engineer’s concurrence, remove all defective material, replace any damaged reinforcing steel, trim the surrounding sound shotcrete edges to an approximate 45-degree slope, thoroughly moisten the sloped edge, and replace the section with specification-compliant shotcrete.

Two-panel pool shell cross-section showing 90-degree nozzle placement at 2 to 6 feet with rebound cleared from the floor-to-wall cove alongside a 45-degree sloped interruption joint and cold- and hot-weather temperature limits
Nozzle orientation, floor-cove rebound clearing, 45-degree interruption joint preparation, and USDA NRCS CS 33 / ACI 506R temperature and curing boundaries.

How do curing duration, placement pauses, and weather temperatures affect shell PSI?

Even a properly batched 4,000 psi mix loses near-surface strength and durability if shooting pauses create unbonded cold joints, weather pushes fresh concrete outside safe temperature limits, or early drying halts cement hydration.

  • Placement pauses over 1 hour: Under USDA NRCS CS 33, whenever shotcrete placement stops for more than 1 hour, crews must slope the layer edge at roughly 45 degrees, cover the sloped edge with a double layer of 6-ounce burlap kept continuously moist, and clean and wet the joint with an air-and-water blast before resuming.
  • Minimum 7-day continuous moist cure: CS 33 mandates preventing shotcrete from drying for at least 7 days after placement by keeping exposed surfaces continuously moist via sprinkling, flooding, fog spraying, or wet coverings. For day-by-day pool watering schedules and plaster-release timing, see our concrete curing schedules and watering protocols guide.
  • Curing compound bond exclusion: CS 33 strictly prohibits spraying membrane curing compounds onto subgrade surfaces, construction joints, reinforcing steel, or any surface requiring bond with subsequently placed shotcrete or coatings.
  • Cold-weather and hot-weather limits: CS 33 permits cold-weather placement only when air temperature is at least 40 °F and rising, requires stopping if air temperature falls to 40 °F and continues dropping, and maintains placed shotcrete between 50 °F and 90 °F with aggregates and mixing water capped at 100 °F. In hot weather, CS 33 caps shotcrete temperature during mixing, conveying, and placing at 90 °F, whereas NEH Chapter 14 notes ACI allows up to 95 °F for shotcrete while keeping steel reinforcement at or below 90 °F.

Coordinate these hold points alongside plumbing, deck, and finish milestones in the complete inground pool construction stages guide.

What strength and placement records should you verify before and after shotcrete day?

Attach this verification table to your new-pool project checklist so mix proportions, equipment gauges, panel cores, and rebound disposal have clear numerical pass criteria before shooting begins.

Scroll horizontally to read all columns.

Control gate Quantitative benchmark to verify Responsible party Primary reference
Specified shell strength Minimum 4,000 psi (28 MPa) at 28 days (structural class) Structural engineer & contractor ACI 506R-16 / ASA
Nozzleman credentials At least 1 year process experience, ACI CP-60 certificate, preconstruction panel Shotcrete contractor & engineer USDA NRCS CS 33
Dry-mix gauges & timing Air 50–80 psi (40 psi base plus hose/rise); water 50–100 psi (15 psi over air); within 45 min (15 min over 85 °F) Gun operator & nozzleman USDA NRCS CS 33
Wet-mix batching & timing ASTM C94 ticket, w/cm 0.30–0.42, within 1.5 hr (45 min over 85 °F), zero hand-packing Ready-mix plant & pump crew CS 33 / ASA
Production test panels ASTM C1140 panel at least 18 in. x 18 in. x 6 in., matching orientation, 3 cores per test Testing lab (ASTM C1077) & engineer ASTM C1140 / CS 33
Core curing & 28-day acceptance Lime water 73.4 °F ± 3.0 °F within 24 hr; 3-test average at least f’c; no single test over 500 psi below f’c Certified testing lab & engineer CS 33 / NRMCA CIP 35
Rebound, joints & curing Zero rebound reused; pause over 1 hr sloped 45° under double 6-oz wet burlap; at least 7-day moist cure Nozzle crew & site supervisor CS 33 / ASA

Frequently asked questions

Is gunite stronger than wet-mix shotcrete in PSI for a swimming pool?

No. Gunite is the original trade name for dry-mix shotcrete, and both dry-mix and wet-mix shotcrete produce equal in-place concrete when properly proportioned, placed at 60 to 80 mph impact velocity, and cured. ACI 506R-16 classifies shotcrete at 4,000 psi or higher as structural, and the American Shotcrete Association maintains a 4,000 psi (28 MPa) minimum at 28 days for all shotcrete.

What water-cementitious ratio (w/cm) is used in wet-mix shotcrete vs gunite?

American Shotcrete Association technical guidance places shotcrete at a w/cm of 0.30 to 0.42, compared with 0.40 to 0.50 for most form-and-place concrete. Dry-mix gunite tends toward the lower end of that range because water enters at the nozzle after 3 to 6% aggregate predampening, whereas wet-mix shotcrete arrives ready-mixed under ASTM C94 with its w/cm fixed before pumping.

How do you test a 4,000 psi concrete pool shell properly?

Because pneumatic spraying cannot compact a standard cast cylinder, ASTM C1140 and USDA NRCS Construction Specification 33 require shooting production test panels at least 18 in. square and 6 in. thick in the same vertical or overhead orientation as the work. Three cores per strength test are standard-cured in lime-saturated water at 73.4 °F plus or minus 3.0 °F within 24 hours and broken under ASTM C39 at 28 days.

What 28-day test numbers pass or fail a 4,000 psi specification?

Under NRMCA CIP 35 acceptance rules, the rolling average of 3 consecutive strength tests equals or exceeds the specified 4,000 psi, and no single test may fall more than 500 psi (3.5 MPa) below specified strength (meaning no test below 3,500 psi). A 3- or 7-day break can flag issues early, but it is not a basis for rejecting concrete specified at 28 days.

Why must rebound material be disposed of rather than packed into gunite steps or coves?

Rebound consists mostly of sand and rock that bounced off the receiving surface with very little cement paste, leaving it substantially weaker and more porous than the design mix. Burying rebound in coves, floors, benches, or steps creates weak planes that cause cracking and delaminations, so USDA NRCS CS 33 and ASA require removing and discarding all rebound.

Can a pool crew hand-pack stiff wet-mix concrete into steps if the pump clogs?

No. American Shotcrete Association guidance explains that shotcrete relies on pneumatic impact velocities averaging 50 to 80 mph to compact the concrete, and hand-packing stiff, unpumpable mix leaves random voids, poor bond, lower strength, and higher permeability. USDA NRCS CS 33 mandates discarding any wet-mix concrete that becomes difficult to pump.
